Units 3 and 4 at Mochovce NPP, Slovakia

Units 3 and 4 at Mochovce NPP, Slovakia

The Completion of Mochovce NPP is currently our biggest project

Completion of Units 3 and 4 at the Mochovce Nuclear Power Plant is currently our biggest engineering investment project. We produced and delivered both complete VVER-440 reactors. At this time, we act as the supplier of not only the power plant’s essential operating systems, i.e., the primary circuit and fuel handling part, but also connecting pipes, intermediate cooling circuits, parts of the instrumentation and control system, and maintenance workshops. This contract is very beneficial for us in terms of the maintenance and development of invaluable experience in managing large investment projects.

We are one of the five main suppliers. The contract for the delivery of the key primary circuit and fuel handling systems was concluded with Slovenské elektrárne, a.s. in 2009. In the following years, addenda to the contract were signed, which officially confirmed an extension of the entire contract and an increase in the volume of assembly works as well as the scope of services provided by ŠKODA JS.

Práce na primárním okruhu 3. bloku JE Mochovce

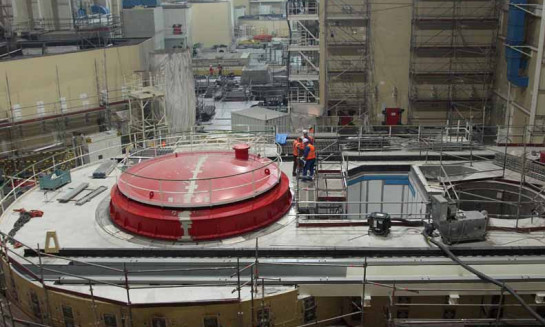

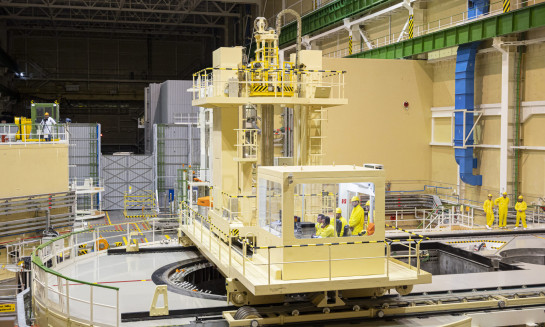

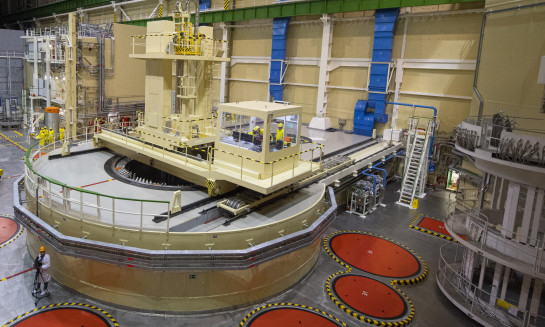

The design, delivery, assembly and cold start-up stages at Unit 3 have been completed. Successful completion of the cold and hot hydrostatic test programs confirmed the high quality of provided assembly works. Thereafter, the stage program of the so-called complex inspection was launched, which was completed by the loading of nuclear fuel. The fuel was loaded into Unit 3 in 2022, which started the phase of physical and power start-up. After a successful 144-hour trial run, the works on Unit 3 will be concluded and the Unit will be handed over to the customer through the preliminary acceptance milestone.

Dokumentace skutečného stavu zařízení elektrárny

Activities leading up to the completion of assembly works and the launch of construction tests continued at Unit 4. The flushes of the piping systems, long-postponed by the investor, are to be performed, which will be followed by removal of the temporary flushing fittings, design-state installations and completion of the construction tests. Subsequently, a sequence of cold tests and stage programs will be started, identical as those at Unit 3.

Throughout the construction process, ŠKODA JS provides the investor with specialists in key areas, such as engineering, planning, licensing support, construction and assembly works and start-up.

The history of our cooperation

The timeline of our cooperation on Units 3 and 4 at Mochovce NPP

Podpis kontraktu na dostavbu 3. a 4. bloku JE Mochove, za ŠKODA JS podepisuje tehdejší generální ředitel Miroslav Fiala (vlevo)

2009 ŠKODA JS and Slovenské elektrárne signed a contract for the completion of Units 3 and 4 at Mochovce NPP

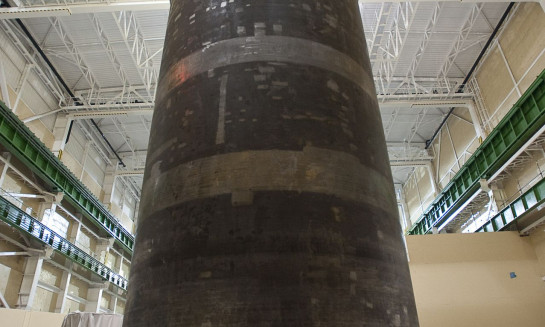

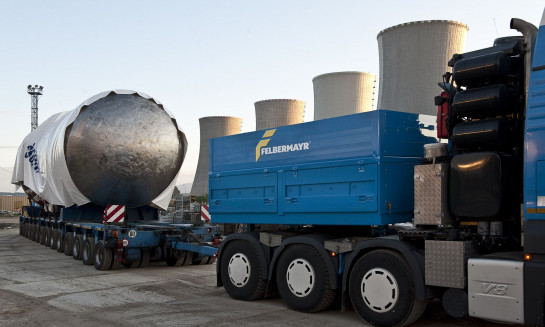

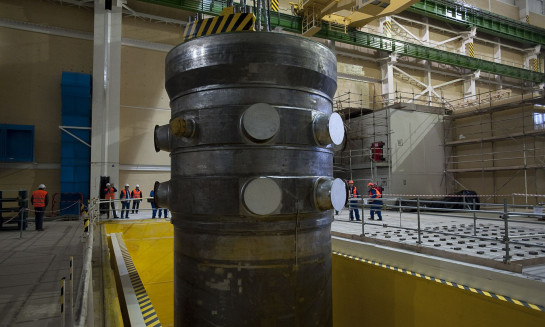

Instalace tlakové nádoby reaktoru na 3. bloku JE Mochovce

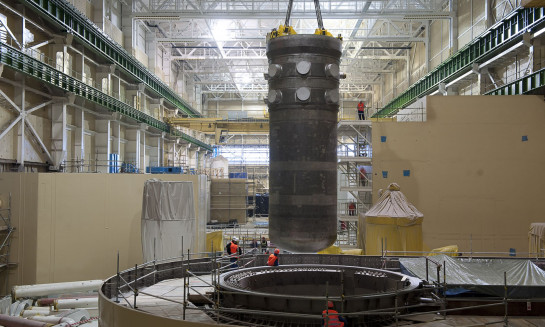

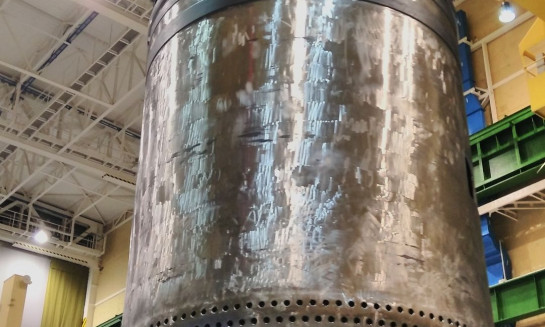

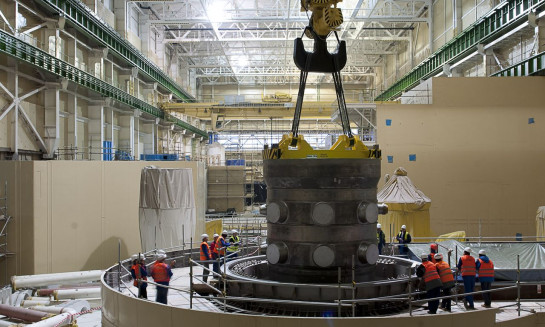

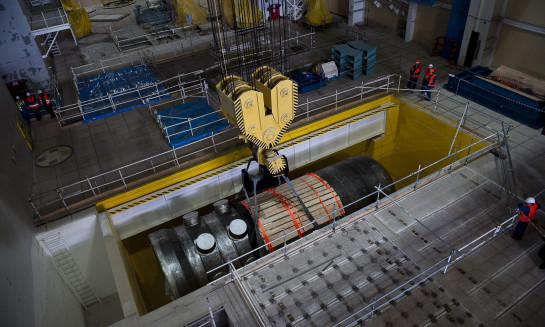

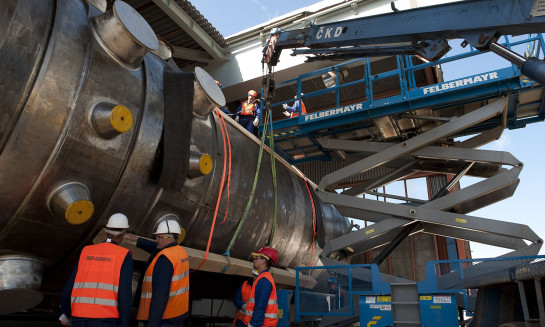

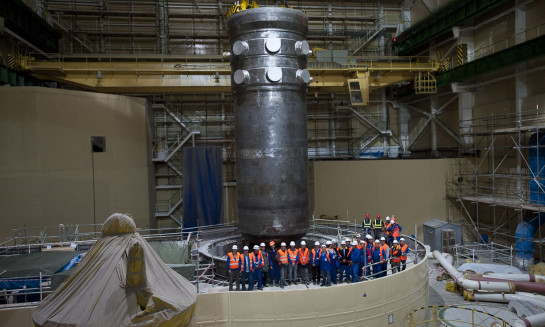

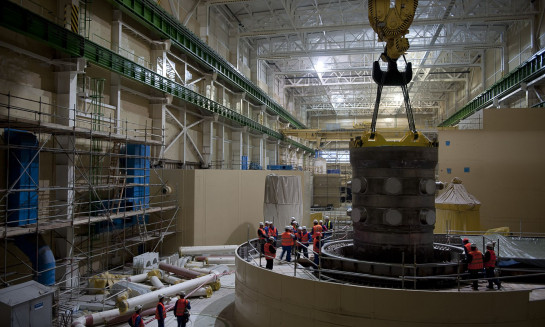

2010 a reactor pressure vessel, produced by ŠKODA JS, was installed at Unit 3

Kontejner KSV 440 na svědečné vzorky oceli tlakové nádoby

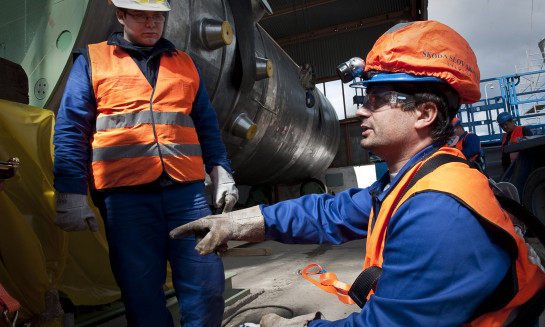

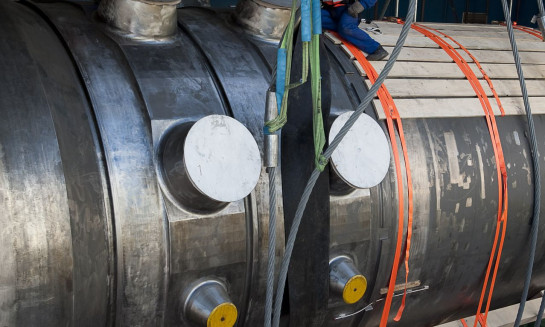

2011 we developed and supplied a special cask of our own design, KSV 440, for witness samples of pressure vessel steel at Units 3 and 4

Zařízení pro vyjmutí, transport a likvidaci čidel neutronového toku a termočlánků z reaktoru VVER 440

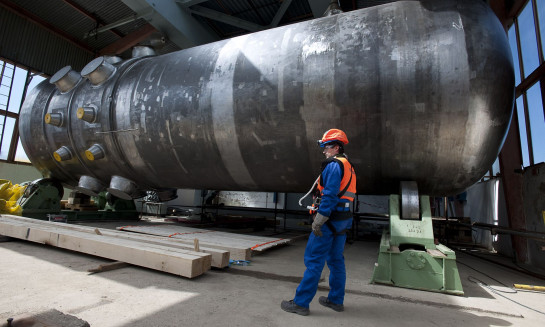

2013 we developed and supplied equipment of our own design for the removal, transport and disposal of neutron flux sensors and thermocouples from the VVER 440 reactor

2013 ŠKODA JS and Slovenské elektrárne signed an addendum to their contract to extend the project and increase the volume of work and services provided by our company

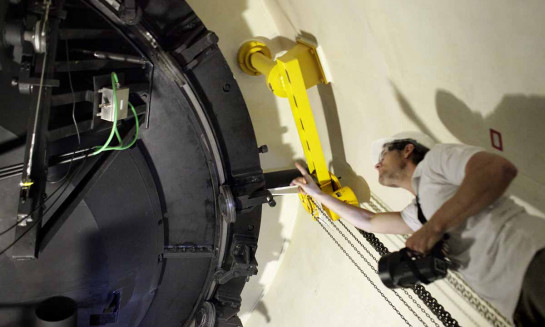

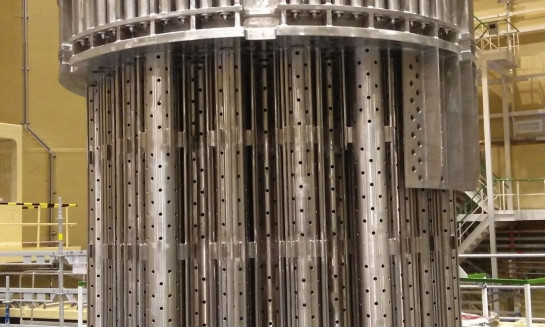

Dokončení kontrolních montáží vnitřních částí reaktoru

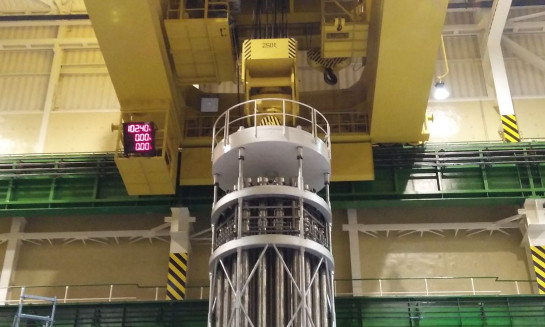

2017 we completed the control assemblies of reactor internals at Unit 4

bezpečnostní zkoušky

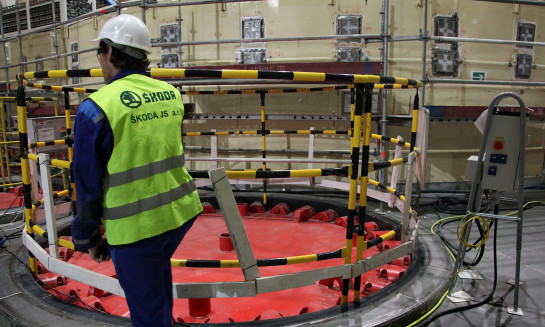

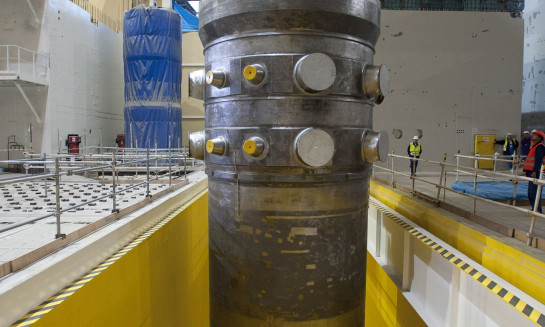

2018 cold hydrostatic testing was performed and the program of hot hydrostatic testing commenced at Unit 3

Assembly works are under way at Unit 4 to be followed by construction tests

2019-2020 hot hydrostatic test program and complex inspection were performed at Unit 3

Interesting numbers

2 reactor pressure vessels
135 control rod drives produced and supplied, of which 45 pcs were delivered between 1985-1988 and 90 pcs in 2014
130 intermediate rods produced and supplied (1985-2015)
2 main flange joint stud tensioners (1990, 2013)
